# LINE Official Account Setup

This guide walks you through the complete setup required to send LINE messages from Engage Studio campaigns. Setup involves three steps: preparing your LINE Official Account, registering authentication credentials in Integration Hub, and configuring a LINE Sender Account in Engage Studio.

## Prerequisites

- An active **LINE Official Account** with Messaging API enabled
- **Channel Secret** and **Channel Access Token** from the LINE Developers Console
- LINE User IDs stored in your Treasure Data CDP profiles (collected via LIFF, LINE Login API, or external import)
- Access to **Integration Hub** in Treasure Data to create authentication credentials
- A **TD Write-only API Key** for delivery log writes


## Step 1: Prepare Your LINE Official Account

### Create a LINE Official Account and Enable Messaging API

If you do not yet have a LINE Official Account with Messaging API enabled:

1. Sign in to [LINE Official Account Manager](https://manager.line.biz/).
2. Create or select your LINE Official Account.
3. Go to **Settings** > **Messaging API**.
4. Click **Enable Messaging API** and link to a LINE Developers channel.


### Obtain API Credentials

From the [LINE Developers Console](https://developers.line.biz/console/):

1. Select your channel (Provider > Channel).
2. On the **Basic Settings** tab, copy the **Channel Secret**.
3. On the **Messaging API** tab, issue or copy a **Channel Access Token (long-lived)**.


## Step 2: Configure LINE Authentication in Integration Hub

Integration Hub stores your LINE API credentials securely and makes them available to Engage Studio.
To create a new Authentication, select **Line OA Streaming Output** from the connector catalog.

### Create a LINE OA Authentication Credential

1. In Treasure Data, go to **Integration Hub**.
2. In the connector catalog, search for **Line OA Streaming**.
3. Select **Line OA Streaming Output** and click **Add Authentication**. The catalog also lists **Line OA Streaming** without *Output*; that entry is the inbound connector and does not send messages.
4. Enter the following:
| Field | Description |
|  --- | --- |
| **Name** | A recognizable label for this credential (e.g., `My Brand LINE OA`) |
| **Channel Access Token** | The token obtained from LINE Developers Console |
5. Click **Save**. The credential is now available for selection in Engage Studio.


## Step 3: Create a LINE Sender Account in Engage Studio

A **LINE Sender Account** links an Integration Hub credential to Engage Studio and configures where delivery logs are written.

### Access LINE OA Configurations

1. In Engage Studio, go to **Configurations**.

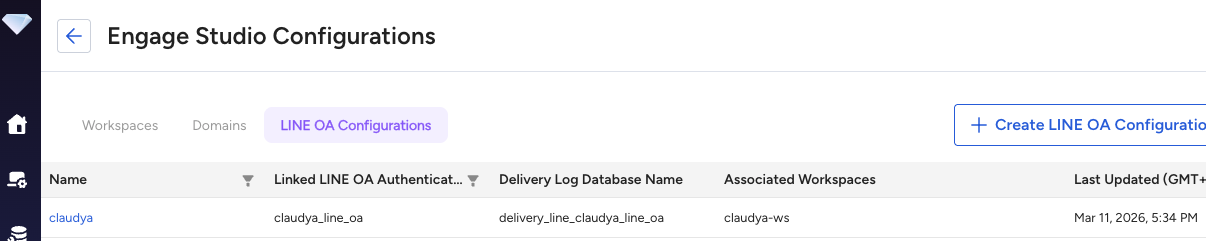

2. Click the **LINE OA Configurations** tab.


### Create a New LINE Sender Account

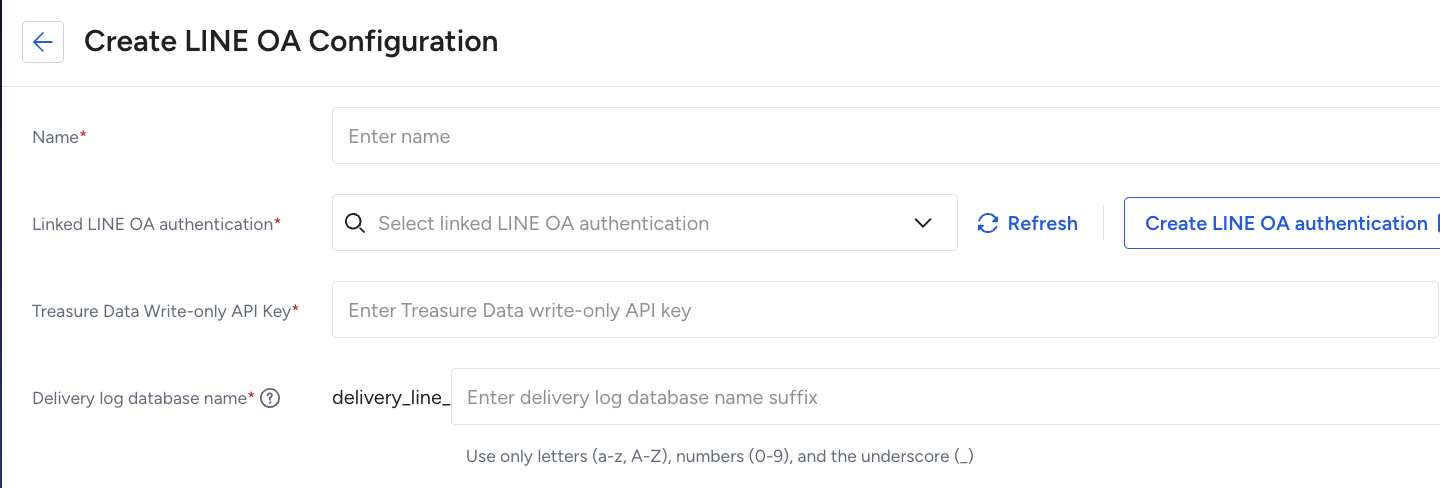

1. Click **+ Create LINE OA configuration**.
2. Fill in the following fields:
| Field | Description | Notes |
|  --- | --- | --- |
| **Name** | Display name for this configuration | Must be unique within your account |
| **Linked LINE OA Authentication** | Select the Integration Hub credential created in Step 2 | Click **Create LINE OA authentication** to create a new one |
| **Treasure Data Write-only API Key** | API key used to write delivery logs to Treasure Data |  |
| **Delivery log database name** | Enter the suffix for the delivery log database | Database name is prefixed with `delivery_line_`. Use only letters (a-z, A-Z), numbers (0-9), and underscores (_) |


1. Click **Save**.


### Delete a LINE Sender Account

You cannot delete a LINE Sender Account that is referenced by campaigns with the status **Planned**, **Active**, or **Finished**. To delete, first cancel any associated campaigns.

## Step 4: Assign the LINE Sender Account to Workspaces

LINE Sender Accounts must be assigned to one or more Workspaces before they can be used in campaigns.

1. In Engage Studio, go to **Configurations** > **Workspaces**.
2. Click **Edit** on the workspace where you want to enable LINE campaigns.
3. In the **LINE OA Configurations** field, select one or more LINE Sender Accounts.
4. Click **Save**.


Once assigned, users in that workspace can select the LINE Sender Account when creating LINE campaigns.
